Serving Greater Lynwood

Hardwood Floor Refinishing

Sanding, refinishing and recoating hardwood floors across Lynwood — with the remaining wear layer measured before a full sand is ever recommended.

Lynwood Wood Flooring has been sanding and refinishing hardwood floors in Lynwood, CA for more than twenty years, serving surrounding cities including South Gate, East Rancho Dominguez, Willowbrook, Compton and Paramount. Refinishing is the largest part of what we do, because most of the housing in this part of Los Angeles County already has wood under it — sometimes under carpet the owner has never lifted.

The first thing worth knowing is that a worn floor and a finished floor are different problems. A floor whose coating has dulled needs the coating renewed. A floor worn through to bare wood needs the wood itself taken back and rebuilt. Those two jobs differ by several times in cost, and the cheaper one is right more often than most people are told.

So we start by measuring rather than quoting. We look at how much wood is left above the tongue, whether the finish is breached or merely tired, and what the boards are actually made of. If your floor does not have enough depth left to survive a full sand, we will tell you that at the estimate — sanding it anyway turns a repairable floor into a replacement.

Refinish or Recoat: The Question That Sets the Price

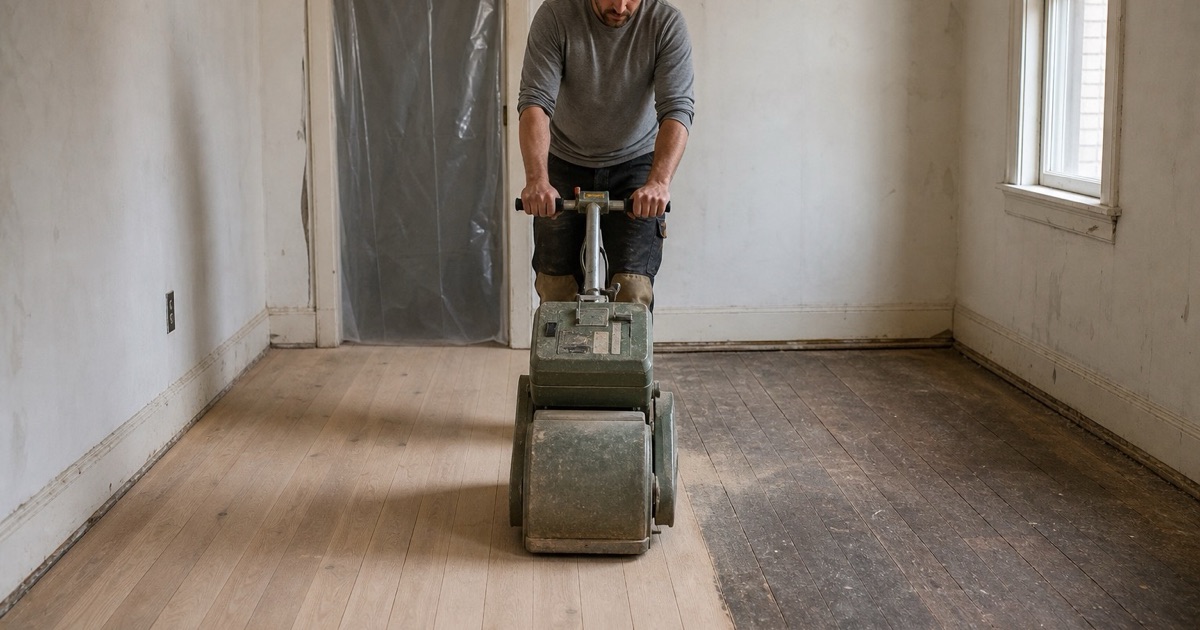

Worker walking a drum sander down a stripped pre-war bedroom, pale bare oak behind the machine and old dark finish still ahead of it.

Full Sand and Refinish

A full refinish takes the floor back to bare wood through a sequence of progressively finer abrasives, then rebuilds the finish from nothing. It is the only route that removes deep scratches, pet stains that have reached the grain, and any existing stain color. It is also the only route that spends wood, which is why we treat it as the answer of last resort rather than the default recommendation.

Screen and Recoat

A screen and recoat abrades only the existing finish, keys it so a new coat will bond, and adds fresh coating over the top. No wood is removed at all. It costs a fraction of refinishing, takes far less time, and leaves the floor’s remaining life untouched. The catch is that it works only while the finish layer is still continuous — once bare wood is showing in a traffic lane, recoating locks that damage under a new surface.

Measuring What Is Left

The decision between the two is not a judgment call if you take a measurement. We find an exposed board edge, usually at a floor vent or a threshold, and read how much sandable wood sits above the tongue. On engineered boards the same reading tells us the wear layer thickness, and some engineered products are simply too thin to sand at all. That number, not the floor’s appearance, decides what we recommend.

What Sanding Actually Takes Off

The Grit Sequence

Sanding is a sequence, not a single pass. A typical full refinish starts around a 36 grit cut to level the floor and remove the old finish, then steps through 50 and 80 to erase the scratch pattern the previous grit left behind. Skipping a step is how a floor ends up with visible sanding marks that only appear once the finish goes on and the light catches them.

Where the Machines Cannot Reach

A drum or belt machine handles the open field, but it cannot get within a few inches of a wall, and it cannot enter a closet or a corner. Those areas are cut with an edger and blended by hand so the transition does not show as a darker band around the room perimeter. Edge work is slow, it is where most of the skill sits, and it is the first thing a rushed job gives up.

Containment and Dust

Our machines run into an extraction and containment system, and we seal the rooms that are not being worked before anything starts. Fine dust still travels, so we would rather set expectations honestly than sell the word dustless as though it meant zero. On pre-1978 houses, which is most of the stock here, containment is not a convenience — it is how the job is done safely.

Color, Stain and Sheen

Changing a Floor’s Color

Once a floor is down to bare wood most colors are available, but the species sets the limits. Red oak’s pink undertone reads through lighter stains, white oak takes a cooler range, and no stain lightens wood beyond its own base tone. We put sample patches on your actual floor and look at them in your own light, because a stain that looked right in another house frequently does not.

Taking a Dark Floor Lighter

Dark stained floors went into a great many houses here over the last two decades, and a lot of owners now want them back toward natural. That is always a full sand, because stain lives in the wood rather than on it. How light the floor can go depends entirely on what species is under the color, which is something we can only confirm by cutting a test area first.

Choosing a Sheen

Sheen is measured as a gloss level, but you choose it by how the room reads. Higher gloss bounces more light and shows every scratch, footprint and dust mote. Matte and satin hide wear and traffic lanes far better, which is why they now dominate. In a room with large windows the sheen choice is usually the difference between a floor that looks calm and one that looks streaked all afternoon.

Our Step-by-Step Hardwood Floor Refinishing Process

Assessment and Wear-Layer Reading

We start at an exposed board edge and establish how much sandable wood remains, then check the worn areas, the room edges and any water staining. This is where the refinish-or-recoat decision gets made, and it is made on a measurement you can see rather than on our opinion of how the floor looks.

Written Scope and Finish Selection

You get a written scope separating material, labor and the add-ons — furniture moving, containment, board replacement, stairs. Finish selection happens here too, from products that can lawfully be sold and applied in this air district, where wood coatings are capped at 275 grams per liter of VOC. That limit is real and local, and it makes the finish shelf here genuinely shorter than in most states.

Preparation and Containment

Furniture comes out, the room gets sealed, and any protruding fasteners are set below the surface so they do not tear an abrasive belt. Loose or damaged boards are replaced at this stage rather than sanded around, because a board that needs replacing after finishing means finishing that area twice.

Sanding and Edge Work

The field is cut through the grit sequence, the perimeter is edged, and corners are finished by hand. Between passes we look at the floor under raking light, which shows scratch patterns that are invisible under normal room lighting and completely obvious once a coating goes over them.

Coating and Cure

Stain goes down first if the floor is being colored, then the coats, with abrasion between them where the product calls for it. We tell you the cure schedule for the specific finish in advance — when it takes foot traffic, when rugs can go down, and when furniture can return. Most avoidable damage to a new floor happens in that window, from furniture arriving before the finish has hardened.

  • 20+ Years in Southeast LA
  • Free Written Estimates
  • Licensed & Insured

Good to know

Frequently Asked Questions

How do I know if my floor needs a full sand or just a recoat?

It comes down to whether the finish is worn or breached. If the coating is dull and scratched but still covering the wood everywhere, a recoat restores the whole floor for a fraction of the cost and spends no wood. Once traffic has worn through to bare timber, or a stain has reached the grain, recoating seals the damage in permanently. We check the worn areas and the room edges before quoting either one.

How many times can this floor be refinished?

It depends on the wood above the tongue, not the floor's age. Each full sanding sequence spends a measurable amount of that depth. Engineered boards have only their wear layer and some are too thin to sand even once. We measure what is actually left, usually at a vent or a threshold where the board edge is visible, and tell you how many passes the floor has in it.

Is dustless sanding really dust free?

No, and we would rather say so. Dustless means the machines run into a containment and extraction system that captures the great majority of dust at the source, which is a large improvement over open sanding. Fine airborne particles still settle. We set containment at the openings and seal off the rooms that are not being worked, so the dust that does escape stays in one part of the house.

Can you change the color of my floor?

Yes, within limits set by the species underneath. Once the floor is sanded to bare wood we can take it in most directions, but red oak carries a pink undertone that shows through lighter stains, which is why so many red oak floors end up restained. We put test patches on your actual boards rather than showing you a sample from another house, because the same stain reads differently on different wood.

How long before we can walk on it and move furniture back?

Light foot traffic usually comes well before full cure, and furniture comes last. The finish continues hardening after it stops feeling wet, and putting weight or rugs down early is the most common way a fresh floor gets marked. We give you the cure schedule for the specific product going on your floor before we start, since waterborne, oil-modified and hardwax oil finishes all behave differently.

Do older houses need anything special?

Most of the housing around here predates 1978, and sanding disturbs whatever coatings have built up on the floor and trim since. We use lead-safe work practices as standard on those homes rather than treating it as an add-on. It changes how the site is set up, contained and cleaned, and it is built into the quote instead of appearing once the machines are already running.

What add-ons should I watch for when comparing quotes?

The ones that make two bids look different when the work is the same: furniture moving, dust containment, per-board replacement, and stairs. A quote that omits them is not cheaper, it is less complete. Ours lists each separately so you can see what is included, and stairs are counted by tread, riser and nosing rather than folded into a square-foot rate.
